Update construction progress of Best Pacific Vietnam Project – Phase 2 to Apr 16, 2019
Contents of construction work
CONSTRUCTION OF HOUSE
- Tiling and foundation bed heave of the wet room, 1st floor, 3rd floor
- Lighting: Installing lights under wind pipe and raise light (11-15) axis, 1st floor. Installing wind formwork and screwing pipe (4-7) axis, 2nd floor. Connect and install source, 3rd floor
- Cable tray: install rack in the chiller room, 1st floor. Connect the cable to the cabinet H / 2F / PP1-2, H / 2F / PP1, 2nd floor. Install ELV trough from (16-19) axis / G 3rd, 4th floor
- Chiller system: Construction of chiller pipe on cooling tower. Installation of chiller pipe, 1st floor. Cover chiller pipe; 2nd floor
- Construction of drainage pipe WC 02;
- Construction of compressed air room on the 2nd floor
- Air conditioning – ventilation: Construction of wind duct on the 1st, 3rd floor
- Construction of pipes on the 3rd floor and installation of pipes on piperack outdoor;
- Fire protection: Installation of fire fight water hose on the 1st,2nd,3rd floor. Installation of fire detector on the 2nd floor;
- Plastering fireproof axis 7, axis 18, 1st floor
- Plastering fireproof axis 7, axis 18, 1st floor
- Construction of hot water tanks;

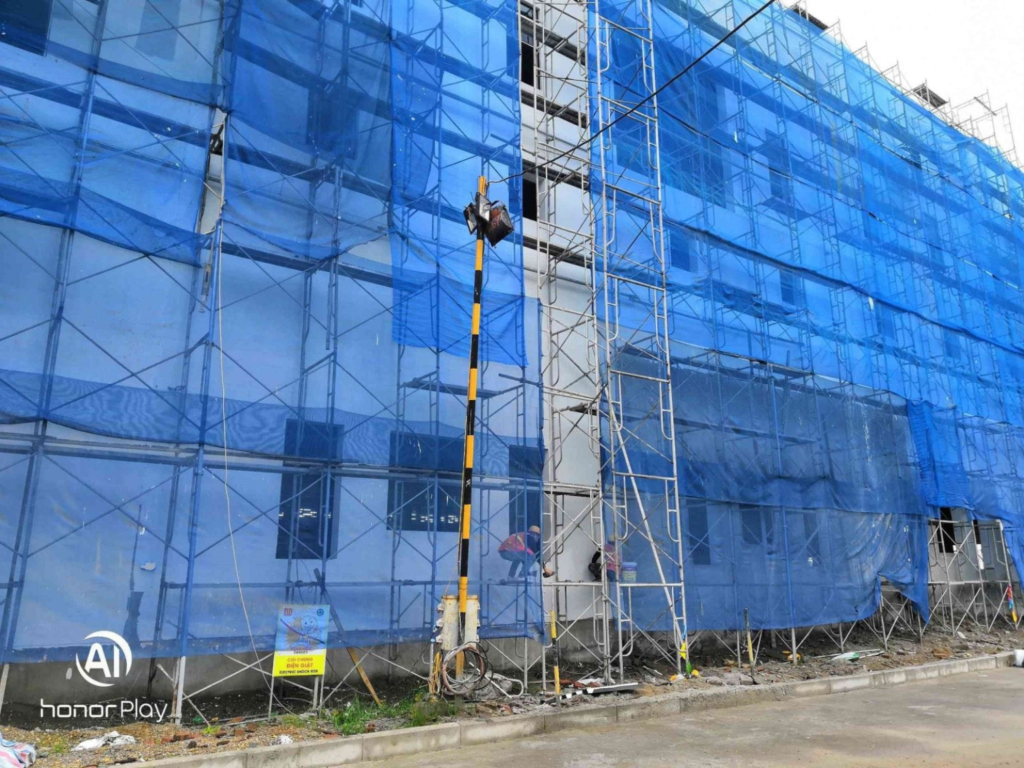

Pictures of construction
