Update Construction Progress Of Xindadong Textiles – Dung Quat On Nov 07, 2019
Progress of construction
TEXTILE FACTORY
– Installation of steel pillars for foundation, axis 19-21 / E-H. Pouring concrete for foundation
– Pour concrete for fan
– Construction of foundation of outhouse
– Installation of base steel

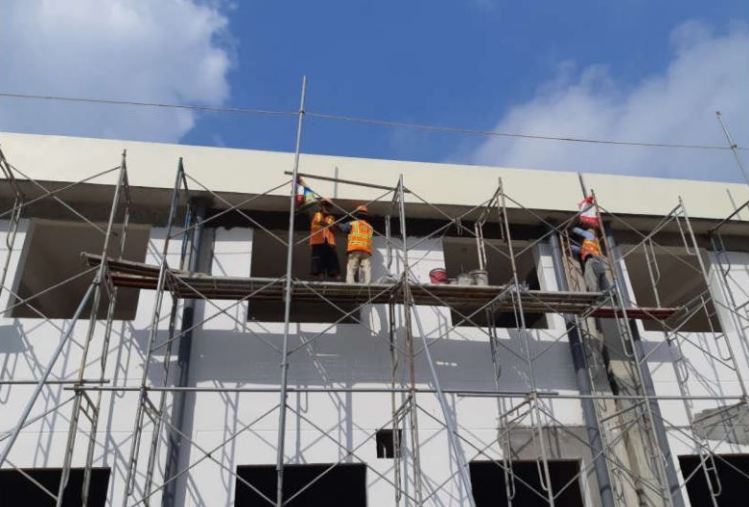

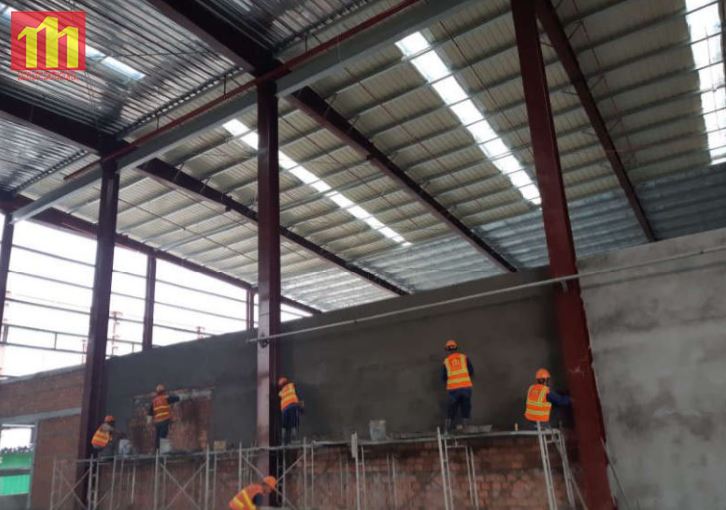

– Building, plastering walls for flow rooms and tiling in house
– Putty matis for attic
– Making wall by corrugated iron, seamlock tole for roof
PREPARATION FACTORY FOR RAW MATERIAL

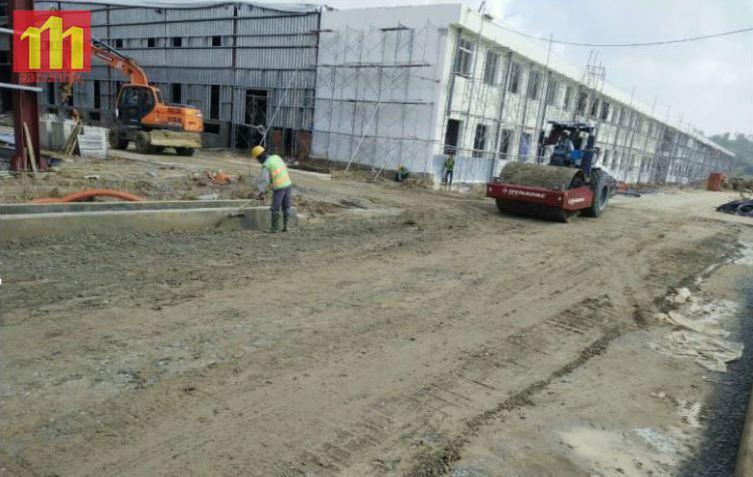

– Concrete maintenance for factory floor
– Suction in drainage ditches in house
– Putty walls, floor beams in house, the 2nd floor, axis A-B / 1-25;
– Building and plastering wall, axis K-M / 5-11, K-C / 25, G / 1-15, C-K / 25, A-B / 9-16
– Plastering wall, axis J-K / 16-20, K / 10-20; G-K / 20, J / 1-20
– corrugated iron for wall, roofing corrugated iron, installing door
– Fabrication and installation of formwork, reinforcement for ditches in the house
INFRASTRUCTURE OUTDOOR
– Completion of manhole cover, installation of wastewater pipes, sections PB5, 4
DORMITORY
– Tiling for 3rd, 4 floor. Tiling toilets and bathrooms on the first floor
– Cleaning to create a slope, glazing seno for 4th floor, build riser
– Pavement of corridor, 2nd floor

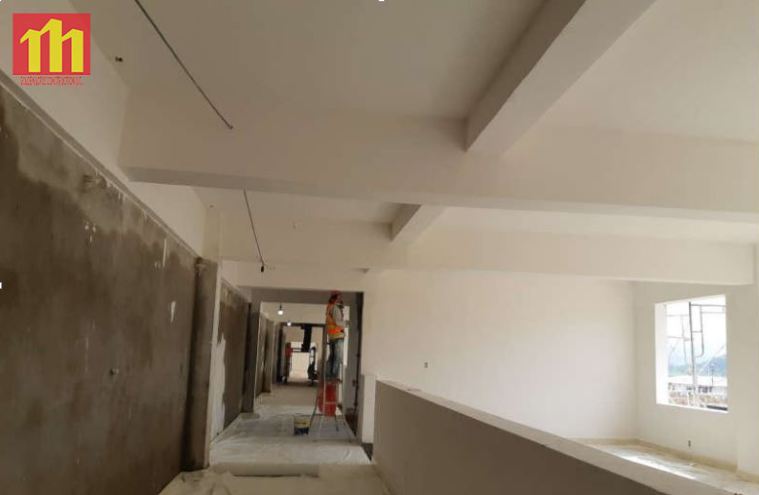

– Putty 1st,2nd ,3rd floor
– Priming on 1st floor, paint on the ceiling, 2nd floor
– Installing windows
WASTEWATER TREATMENT AREA
Tank no.2: remove formwork for wall
MUD SEDIMENTATION TANK
installation of formwork for wall,phase 2
GUARD’S HOUSE
– Building wall of guard’s house no. 1
WAREHOUSE
Spread deck floor, install purlin
– Installation of pneumatic pipe for factory
– Installation of compressed air pipes, water supply pipe
– Installation of electrical pipes for guard’s house
– Installing cables, wind pipes
– Dropping thread rod on lamp rack of textile factory
FIRE PROTECTION
– Installing the detector, cable, installing
– Dropping thread rod, install pipe for the textile factory
