Update Construction Progress Of Xindadong Textiles Project – Dung Quat On Sep 12, 2019

Update Construction Progress Of Xindadong Textiles Project – Dung Quat On Sep 12, 2019

TEXTILE FACTORY

  • Aligning beam reinforcement, mounting steel for beam + 6.9m axis 12-14 / H-G
  • Installation of reinforcement of floor beam + 9.9m
  • Building axis 12-21 / G-H; 23 / E-H; 12-17 / A-B; 22-23 / A-D Installation of reinforcement of floor beam +6.9m, axis 13-14 / A-B

PREPARATION FACTORY FOR RAW MATERIAL

  • Installation of floor beam scaffolding on the 3rd floor, axis K-M / 5-11
  • Plastering exterior walls, axis B / 1-9, Plastering interior walls of axis A-B / 16 -25.
  • Pour concrete to wall bracing, axis 1 / C-G
  • Construction of wall, 2nd floor, axis L / 11-17; L / 1-5; A-B / 9-16
  • Installation of steel beam, zone 5, 6

WASTEWATER TREATMENT AREA

  • Tank No. 1: fabrication and installation of reinforcement, formwork, pouring concrete to floor beam, tank lid
  • Tank No. 3: grinding surface of tank wall, installation of reinforcement, formwork for hanging wall
  • Tank No. 5: fabrication and installation of reinforcement, formwork of bracing beam
  • Tank No. 4: Grinding to complete surface

INFRASTRUCTURE OUTDOOR

  • Compacting stone foundation for street D1, N3
  • Rolling road-bed for street N1 and D3, leveling the pavement of the raw material factory

DORMITORY

  • Building and plastering 2nd floor, axis 1-15 / A-D
  • Fabrication and installation, pouring concrete for floor of attic
  • 3rd floor ceiling grinding

WAREHOUSE

Pause

GUARD’S HOUSE

  • Installation of formwork for floor beam of guard’s house no. 1

BOILER HOUSE

  • Fabrication and installation of formwork, reinforcement for foundation

Rolling floor, leveling ground

FIRE FIGHTING PUMP ROOM, WATER TANK

Fabrication and installation of reinforcement for wall

ME SYSTEM

  • Construction of textile factory supply pipes, chiseling, installing of supply and drainage pipe for raw material factory
  • Construction of chiseling textile factory, put supply and drainage pipe for dormitory, placing street lamp pillars.
  • Chiseling, installing fire alarm pipes in textile factory, installing supply pipes outside factory, pipe fabrication

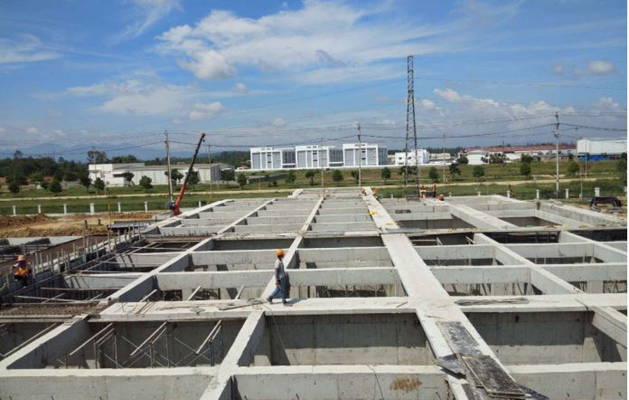

Pictures of construction

Update Construction Progress Of Xindadong Textiles Project – Dung Quat On Sep 12, 2019
Update Construction Progress Of Xindadong Textiles Project – Dung Quat On Sep 12, 2019
Update Construction Progress Of Xindadong Textiles Project – Dung Quat On Sep 12, 2019
Update Construction Progress Of Xindadong Textiles Project – Dung Quat On Sep 12, 2019
